Victoria Granny Flat Rules Cost 2026: What You’ll Pay

Victoria Granny Flat Rules Cost 2026: What Each Rule Costs You
Amendment VC253, planning permits, setbacks & overlays — with the exact compliance cost each rule adds to your budget
Quick Facts — VIC Granny Flat Rules & Compliance Costs 2026
Dec 2023
Amendment VC253 — planning permit removed for most 60m² builds
$5k–$15k
Saved by avoiding planning permit under VC253
$3k–$28k+
Extra cost when overlays apply — heritage, bushfire, flood
Always
Building permit required — no exceptions, even under VC253What’s in This Guide
- Amendment VC253 — what changed & how much it saves
- Planning permit — when you need one & what it costs
- Building permit — always required, exact cost breakdown
- Setback & siting rules — per-rule cost impact
- Overlay costs — heritage, bushfire & flood
- NCC compliance — 7-star & livable housing costs
- Compliance cost summary table
- Step-by-step approval checklist
- Frequently asked questions

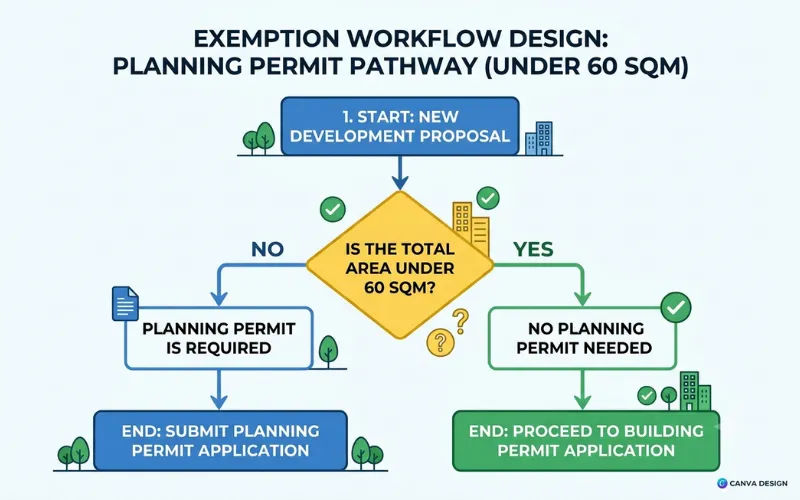

Amendment VC253 — What Changed & How Much It Saves
Before December 2023, every granny flat in Victoria needed both a planning permit and a building permit. Amendment VC253 changed that — and it’s the single biggest cost-saving rule change in Victorian granny flat history. Here’s exactly what it means for your budget.

Do You Qualify for the VC253 Exemption?
Gross floor area must not exceed 60m². Design to 58–59m² to stay safely within the threshold.
Your property must be at least 300m². Unlike NSW (450m²), Victoria’s minimum lot size is smaller.
Must be in a residential or rural zone. The exemption applies across most standard Victorian zones.
Heritage overlays trigger a planning permit requirement — regardless of size or zone.
Flood management overlays require council planning approval even for small builds.
Bushfire Management Overlays (BMO) require planning approval and BAL-rated construction.
VC266 Update (March 2026): Amendment VC266 extended the transition period for existing Dependent Person’s Units (DPUs) built under the old rules. DPUs that were already approved or under construction had until 28 March 2026 to adapt. If you have an existing DPU on your property, check its status with your council. New builds follow VC253 rules. Verify your property overlays at Planning Victoria.
Planning Permit — When You Need One & What It Costs
Most Victorian homeowners won’t need a planning permit in 2026 — thanks to Amendment VC253. But certain site conditions bring it straight back. Knowing your triggers before you engage a designer saves thousands in wasted plans.

What Triggers a Planning Permit?
Over 60m² Floor Area
Planning permit + $3,000–$8,000 council feesExceed 60m² gross floor area by even one square metre and the VC253 exemption disappears entirely. You fall into the standard planning permit pathway — and months of wait time.
Lot Under 300m²
Planning permit required — council discretionVictoria’s 300m² minimum lot size is smaller than NSW (450m²) but still applies. Sub-300m² blocks need planning approval regardless of the granny flat’s size or design.
Heritage Overlay (HO)
+$5,000–$12,000 (design + fees)Heritage overlays are common in inner Melbourne suburbs — Fitzroy, Collingwood, Carlton, Richmond. A heritage-sensitive design and heritage impact statement are required on top of standard permit fees.
Flood or Bushfire Overlay
+$3,000–$6,000 in reports aloneFloodway, Land Subject to Inundation, or Bushfire Management Overlays all trigger planning approval. Engineering and risk reports are required before a planning application can be assessed.
Setback Non-Compliance
Varies — redesign or variation applicationIf your preferred placement doesn’t meet the standard siting rules, you’ll need a planning permit to seek a variation. Redesigning to comply is almost always cheaper than the permit path.
Environmental Significance Overlay
+$2,000–$5,000 in ecological reportsProperties near waterways, wildlife corridors, or native vegetation may carry an ESO. Ecological assessments and specific design conditions are typically required.
| Planning Permit Cost Item | Typical Range | Notes |
|---|---|---|
| Council application fee | $1,300–$3,500 | Based on construction value — varies by council |
| Town planner fees | $2,000–$5,000 | Required to prepare and lodge the application |
| Heritage impact statement | $1,500–$4,000 | Only on heritage overlay properties |
| Engineering / flood reports | $1,500–$4,000 | Required on flood or environmental overlay sites |
| Redesign costs (if required) | $1,000–$3,000 | Council may require design changes during assessment |
| Holding costs (8–16 weeks) | Project-specific | Finance, rent, or opportunity cost during wait |
Building Permit — Always Required, Exact Cost Breakdown
No matter how simple your granny flat design, a building permit is non-negotiable in Victoria. This covers structural safety, fire separation, energy efficiency, and NCC compliance. It cannot be skipped — not even under Amendment VC253.

🏗️ Structural Safety
The surveyor checks your engineer’s plans for structural integrity — foundations, frame, roof. Reactive clay or sloped sites require additional engineering documentation.
🔥 Fire Separation
The granny flat must be fire-separated from the main dwelling. This includes fire-rated wall construction and specific setback distances between the two structures.
⚡ NCC Energy Compliance
7-star NatHERS rating is mandatory since May 2024. Your energy report must be submitted with permit documents — Melbourne’s cold climate makes compliance more demanding than other states.
🚿 Waterproofing & Drainage
Bathroom and wet area waterproofing is inspected at construction stage. Stormwater connection and disposal must be shown in plans before permit is issued.
♿ Livable Housing Standards
NCC 2022 requires step-free entry, wider doorways (820mm minimum), and reinforced bathroom walls. These must be in the plans — retrofitting costs significantly more.
🔍 Staged Inspections
Three mandatory site visits: slab stage, frame stage, and final completion. You cannot occupy the flat until the final inspection certificate is issued.
| Building Permit Cost Item | Typical Cost | Notes |
|---|---|---|
| Building surveyor fee | $2,500–$4,000 | 1–1.5% of construction value — private surveyor |
| Structural engineering | $800–$2,500 | Required for slab design and frame sign-off |
| NatHERS energy report | $400–$1,200 | 7-star mandatory as of May 2024 in VIC |
| Soil / geotechnical test | $500–$1,500 | Determines slab type — essential in Melbourne clay areas |
| Staged inspection fees | Included in surveyor fee | 3 mandatory inspections — slab, frame, completion |
| Home Warranty Insurance | Varies | Mandatory from July 2026 for builds over $20,000 |
Setback & Siting Rules — What Each Rule Costs When You Fail It
Setback rules determine where on your block the granny flat can physically sit. Get them wrong and you face one of two costs: a redesign (cheapest) or a planning permit variation application (expensive and slow). Know the rules before your designer starts drawing.

| Setback Rule | VIC Standard (ResCode) | Cost if You Fail It | Notes |
|---|---|---|---|
| Side boundary setback | 1m minimum (walls under 3.6m high) | Redesign: $800–$2,000 | Most common failure point in Melbourne builds — tight blocks push flat too close to fence |
| Rear boundary setback | Varies by council — check local scheme | Redesign or variation: $1,500–$5,000 | Some councils require 3m+ rear setback — always check your council’s planning scheme, not just state rules |
| Front setback | Behind main dwelling’s building line | Usually non-issue — granny flat stays at rear | Most builds sit in the rear yard well behind the front of the main house |
| Height limit | 8.5m maximum / 2 storeys | Redesign — lower roof: $1,000–$3,000 | Single-storey granny flats rarely hit this — only an issue on sloped sites with elevated slabs |
| Fire separation from main dwelling | Specific fire-rated wall required | +$2,000–$6,000 in fire-rated construction | Mandatory regardless of setback — cannot be avoided. Design your floor plan around it |
| Privacy screening | Required on habitable room windows facing neighbour | +$500–$2,000 per screen | Often overlooked at design stage — screen placement affects natural light and layout |
Overlay Costs — Heritage, Bushfire & Flood
Overlays are the biggest hidden cost variable in Victorian granny flat projects. They override the VC253 exemption, trigger planning permits, and add significant compliance costs. Check your overlays before you spend a dollar on design.

NCC Compliance Costs — 7-Star & Livable Housing
The National Construction Code (NCC) 2022 introduced two mandatory requirements that directly add cost to every Victorian granny flat. These are not optional — they apply to all new secondary dwellings regardless of size or approval path.
⭐ 7-Star NatHERS Energy Rating
+$8,000–$20,000 in MelbourneMandatory since May 2024. Melbourne’s cold climate and small footprint (high wall-to-floor ratio) makes 7-star hard to achieve cheaply. Double glazing, upgraded insulation, and a heat pump hot water system are typically required. Design for it from day one — retrofitting costs 40% more.
♿ Livable Housing Design Standards
+$2,000–$6,000 if not designed inNCC 2022 requires step-free (flush) entry, 820mm minimum doorways, wider corridors, and reinforced bathroom walls for future grab rails. These features add minimal cost when designed from scratch — but $2,000–$6,000 if retrofitted after plans are drawn.
🔧 Separate Electrical Metering
+$2,000–$4,000Victorian regulations require a separate electrical sub-meter or meter for any granny flat rented to a tenant. This is often missed in builder quotes — and it’s not optional if you’re renting. Budget for it from day one.
🏠 Home Warranty Insurance
Varies by build costFrom July 2026, Home Warranty (formerly Domestic Building Insurance) is mandatory for all VIC builds over $20,000. Your builder must purchase it on your behalf before work begins. Check your builder has obtained it — you cannot legally occupy the flat without it.
Compliance Cost Summary — Simple vs Complex VIC Build
Every compliance item has a cost. Here’s a full side-by-side comparison of a simple standard Melbourne block versus a complex site with overlays — so you can see exactly where the money goes.
| Compliance Item | Simple Block (no overlays) | Complex Site (with overlays) | Notes |
|---|---|---|---|
| Building surveyor | $2,500–$3,500 | $3,500–$4,500 | Always required |
| Structural engineering | $800–$1,500 | $1,500–$3,000 | Higher on clay or sloped sites |
| NatHERS energy report | $400–$800 | $800–$1,200 | 7-star mandatory since May 2024 |
| Soil/geotechnical test | $500–$1,000 | $1,000–$1,500 | Reactive clay adds slab cost |
| Planning permit | $0 (VC253 exempt) | $3,000–$8,000 | Only when overlays apply |
| Overlay-specific reports | $0 | $1,500–$5,000 | Heritage, BAL, flood reports |
| Overlay construction upgrade | $0 | $5,000–$28,000 | BAL-rated materials, raised floors |
| 7-star energy upgrade | $4,000–$8,000 | $8,000–$20,000 | Melbourne climate makes this costly |
| Separate electrical meter | $2,000–$3,000 | $2,000–$4,000 | Required for rental tenants |
| Livable housing features | $500–$1,000 | $500–$1,000 | Designed in from start — minimal cost |
| Total compliance costs | $10,700–$18,800 | $26,800–$75,200 | On top of base build quote |
Step-by-Step Approval Checklist — Before You Spend Anything
Follow this sequence before engaging a designer, builder, or certifier. Every step here saves money — the further along you are when you discover a problem, the more it costs to fix.

Order a Certificate of Title
Saves: $3,000–$10,000 in wasted design feesCheck for easements, covenants, and encumbrances that could prevent construction or restrict placement. A title search costs $15–$30 — worth every cent before you spend anything on plans.
Check Your Overlays Online
Saves: $5,000–$30,000 in surprise overlay costsSearch your address on your council’s online planning map or the VicPlan tool. Look for Heritage (HO), Bushfire Management (BMO), Land Subject to Inundation (LSIO), and Environmental Significance (ESO) overlays before designing anything.
Call Your Council’s Duty Planner
Free — and often the most valuable call you’ll makeA 15-minute call with the duty planner confirms whether your block qualifies for the VC253 exemption and whether any local conditions apply. This is a free service — use it. Every Melbourne council has one.
Get a Soil Test Done
Saves: $6,000–$11,000 in slab upgrade surprisesA geotechnical soil test ($500–$1,500) identifies whether you’re on reactive clay — common in Melbourne’s west and north. Without it, builders quote Class M (standard slab). Finding Class H or E soil after you’ve signed a contract triggers expensive variations.
Design to 58–59m² — Not 60m²
Saves: $3,000–$8,000 in planning permit costsStay comfortably under the 60m² threshold. Internal measurements at construction sometimes run slightly larger than plans — a design at 59m² keeps you safely within the VC253 exemption even with minor construction variance.
Engage a Registered Building Surveyor Early
Avoids delays and costly redesigns at permit stageBring your building surveyor in before plans are finalised — not after. They’ll identify NCC compliance issues, setback problems, and fire separation requirements before your designer commits to a layout that can’t pass inspection.
Frequently Asked Questions — VIC Granny Flat Rules & Costs
Know the Rules — Now Get the Right Builder
A builder who understands VIC compliance rules saves you money. One who doesn’t costs you variations, delays, and failed inspections. Compare licensed Victorian builders who know the VC253 rules — free and no obligation.
Get Free Builder Quotes →Builder-neutral — we don’t take commissions from builders.
